As a young married couple who has gotten our first home, it seems to be the trend to hack one of the common bedrooms. The more common layout is hacking 2 bedrooms into 1 and having one walk-in wardrobe.
For us, we decided to make the living room larger the moment we first saw the floor plan. It was a no-brainer and I will be talking about the cost, the timeline and the application needed to hack your common bedroom.
Timeline
14/2 - ID applied permit
16/2 - HDB returned application

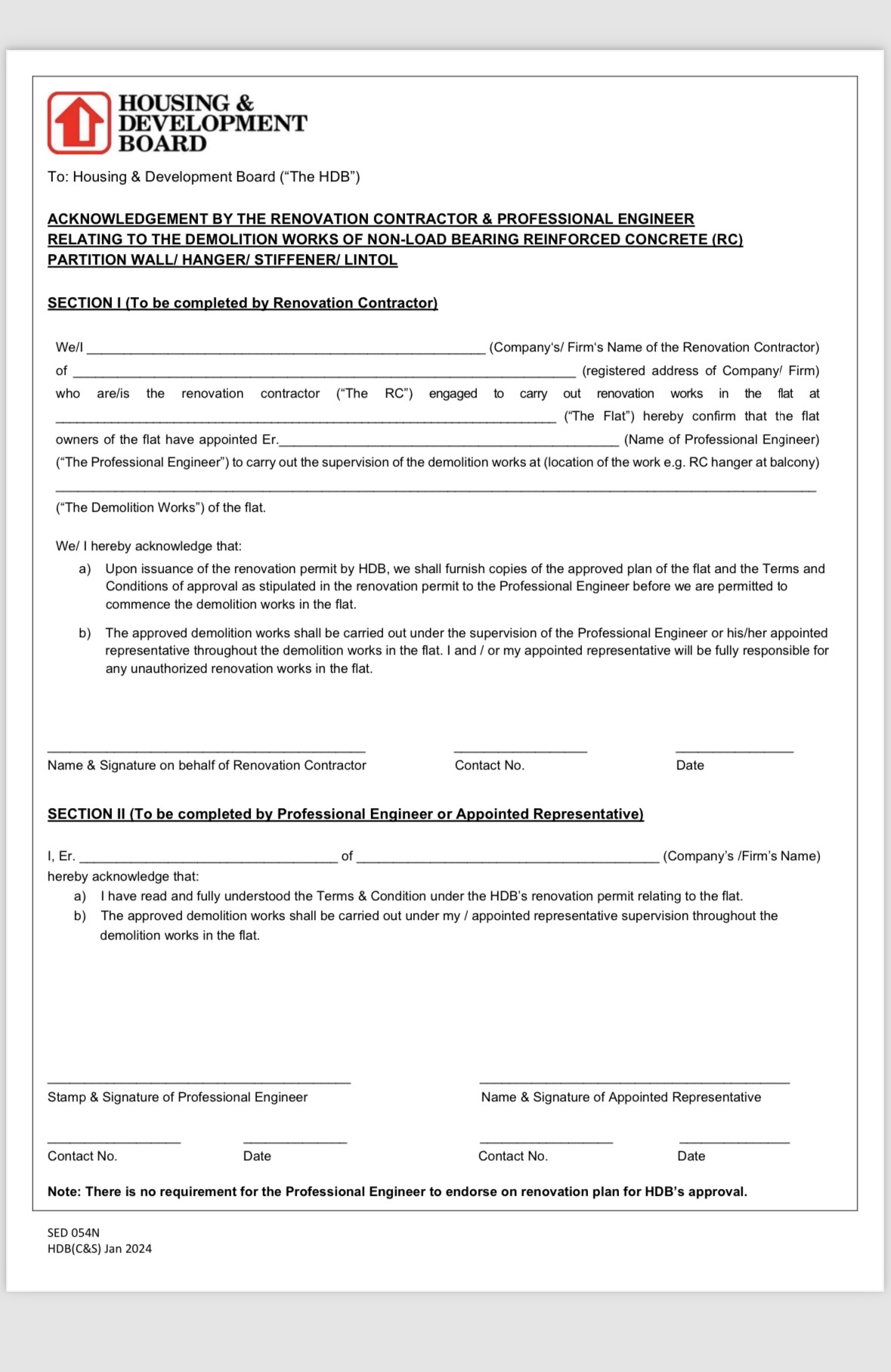

17/2 - paid PE endorsement to hacking company
19/2 - ID obtained PE endorsement and resubmitted application
20/2 - HDB returned application due to wrong blk no. (The hacking company wrote the wrong blk)
26/2 - 1st hacking works postponed as application not approved yet
27/2 - hacking permit approved
5/3 - start of hacking works
Looking back, we would’ve made the initial hacking date but was held up by the incorrect application twice.
Also just for clarification, the hacking works was done by the ID’s workers.
PE endorsement paid to hacking company: $450
Once the wall was hacked, we see metal frames all around the existing wall. The professional engineer (PE) is also there to ensure safety and structural integrity and certify whether it is a load bearing wall.
The workers then cut the metal structure one by one and the hacking only took half a day.
The vinyl tiles were a headache by the way. Since the vinyl tiles in the former bedroom was placed when the walls were up, the workers removed everything and placed new tiles.
We had to get around 7 boxes of new vinyl tiles for the new living room. The gap in replacement is because we wanted to wait until majority of the renovation has been done before changing to the new tiles in case there were more damages to the tiles.
For eg, indented tiles, scratched tiles, has silicon glue on the tile, etc…
Vinyl timeline
29/4 - placing the new vinyl tiles
22/6 - replacement of damaged vinyl tiles
